Free template

Free Construction Documents and Closeout Template

Closeout is where a building project drifts for months: the punch list that never quite closes, the manuals nobody delivered, the retainage released too early. This template plans it from the day the construction documents are issued, with a closeout list agreed at preconstruction, submittals and RFIs through construction administration, a punch list backed to zero, and every manual, warranty, record drawing and lien waiver in hand before final payment.

Planning the whole appointment, from schematic design onward? Start from the AIA design phases template.

No credit card. Opens as a real project on the Free plan.

The spreadsheet is a 18-task plan with phases, durations and milestones, ready for Excel or Google Sheets. It carries no dates, so set your own start, or paste it into the Gantt chart generator to have the schedule built for you. Want to compare the plans side by side first? Every one of them is on the project plan template page, with the rows shown before you download.

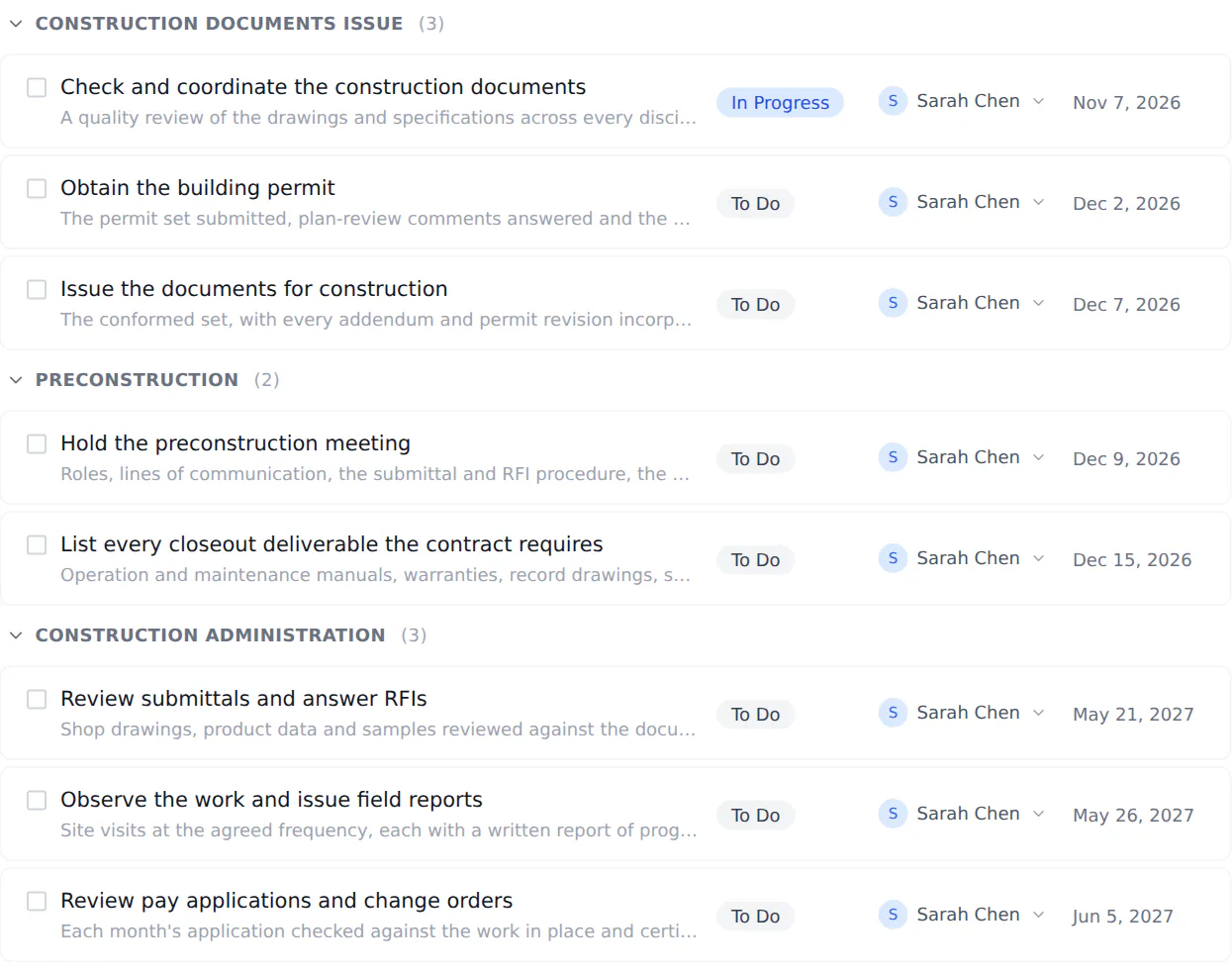

The Construction Documents and Closeout template as a real project in Onplana: its first phases in order, each task with a status, an owner and a due date. The full plan is below.

What’s inside

All 18 tasks are below, from the construction documents check to the warranty walkthrough, each with its description, duration and priority. The closeout documents are collected after substantial completion, but the list of them is agreed at preconstruction, months before.

18

Scheduled tasks

6

Phases

5

Milestones

~38

Weeks end to end

Why closeout is planned at preconstruction

Most closeout trouble is set up months earlier. The specifications ask for operation and maintenance manuals, warranties, spare materials, training and record drawings, and nobody lists them until the owner asks where they are. This plan makes that list a task in the first week of construction, with who provides each item, so the closeout documents are tracked from the start instead of chased at the end. The one task already in progress when you open the plan is the coordination check of the construction documents, because a gap found before issue costs a sketch, and the same gap found on site costs a change order.

Construction administration runs as three long tasks side by side: submittals and RFIs, site observation and field reports, and pay applications and change orders. That is how the work arrives, continuously and at the contractor's pace. Each task carries an estimate, and hours logged against it stay on it, so the time construction administration takes is recorded where it was spent. Onplana does not yet total hours per phase, so setting construction administration against its share of the fee is a sum you make from its tasks. A response that changes scope goes out as a change order and is never absorbed, which is the habit that protects the fee.

Substantial completion and final completion are separate milestones on purpose. Substantial completion fixes the date the owner can occupy and the warranties start, and it produces the punch list. Final completion comes when the punch list is backed to zero on site, every closeout document is in hand and the lien waivers and the consent of surety are collected, and only then is final payment certified and the retainage released. The last task puts the 11-month warranty walkthrough in the calendar before the team disbands, so warranty items are found while the contractor still has to fix them.

The plan, phase by phase

Construction Documents Issue3 tasks

Check and coordinate the construction documents

A quality review of the drawings and specifications across every discipline before anything is issued: clashes, missing details, and specification sections that contradict the drawings.

15 daysCritical

Obtain the building permit

The permit set submitted, plan-review comments answered and the permit issued, with any conditions recorded against the work they affect.

30 daysHigh

Issue the documents for construction

The conformed set, with every addendum and permit revision incorporated, issued to the contractor as the one set the work is built from.

5 daysCritical

Preconstruction2 tasks

Hold the preconstruction meeting

Roles, lines of communication, the submittal and RFI procedure, the pay application schedule, and how changes are priced and approved.

2 daysHigh

List every closeout deliverable the contract requires

Operation and maintenance manuals, warranties, record drawings, spare materials, training and lien waivers, each with who provides it, so closeout is planned from the first week.

8 daysHigh

Construction Administration3 tasks

Review submittals and answer RFIs

Shop drawings, product data and samples reviewed against the documents, and RFIs answered, with turnaround tracked. A response that changes scope goes out as a change order, never absorbed.

160 daysHigh

Observe the work and issue field reports

Site visits at the agreed frequency, each with a written report of progress, deviations from the documents, and anything the owner needs to decide.

165 daysHigh

Review pay applications and change orders

Each month's application checked against the work in place and certified, and every change order priced and approved before the work it covers.

170 daysHigh

Substantial Completion3 tasks

Run commissioning and owner training

Building systems tested against the design intent, and the owner's staff trained to run them, before the owner takes the building over.

15 daysHigh

Inspect for substantial completion and issue the punch list

The inspection the contractor asks for when the work is ready, and a punch list of every item still to finish or correct.

5 daysCritical

Certify substantial completion

The certificate, with the punch list attached. It fixes the date the owner can occupy and the warranties start.

2 daysCritical

Closeout Documents3 tasks

Collect the O&M manuals, warranties and attic stock

Every operation and maintenance manual, warranty and spare material the specifications call for, checked against the closeout list from preconstruction.

20 daysHigh

Assemble the record drawings

The contractor's as-built markups turned into record documents, so the owner has drawings of the building that was actually built.

25 daysHigh

Collect lien waivers and the consent of surety

Final lien waivers from the contractor and the subcontractors, and the surety's consent to final payment, before any retainage is released.

15 daysHigh

Final Completion and Payment4 tasks

Back-check the punch list to zero

Each item verified on site, not taken on the contractor's word. Anything still open is valued and held back from final payment.

20 daysHigh

Inspect for final completion and certify final payment

The final inspection, then the final certificate for payment and the release of retainage, once every closeout document is in hand.

5 daysCritical

Close out the project and reconcile the fee

Project records archived, the fee reconciled against the agreement, and the lessons written down while the team still remembers them.

5 daysHigh

Schedule the 11-month warranty walkthrough

Put the date in the calendar before the team disbands, so warranty items are found while the contractor still has to fix them.

1 dayMedium

Milestones

Five milestones: documents issued, construction start, substantial completion, final completion and project closed out. On the Gantt chart the gap between substantial and final completion is the closeout itself, and it is the stretch most worth watching.

Construction documents issued

Day 45 of the plan

Construction start

Day 50 of the plan

Substantial completion

Day 227 of the plan

Final completion

Day 257 of the plan

Project closed out

Day 262 of the plan

Frequently asked

Is this a construction closeout checklist?

Yes, and a schedule. Every closeout item a typical specification asks for is a task: the punch list, O&M manuals, warranties, attic stock, record drawings, lien waivers and the consent of surety, final payment and the warranty walkthrough. Download it as a spreadsheet and it works as a checklist in Excel or Google Sheets; open it in Onplana and each item has a date, an owner and a place for comments.

Is it written for the architect or the contractor?

For the architect or engineer running construction administration: reviewing submittals, answering RFIs, certifying pay applications and completion, and collecting the closeout documents for the owner. A contractor's project manager will recognise every step from the other side of the table, and can reword the tasks in a few minutes.

How does it fit with the AIA and RIBA templates?

Those two run the whole appointment stage by stage, with a client sign-off closing each design stage, and they cover construction in a few long tasks. This one starts where the construction documents are issued and breaks construction administration and closeout into the steps that take the time. Use the AIA or RIBA template for a new appointment, and this one for a project already in construction or to plan closeout in detail. In RIBA terms it covers Stages 5 and 6: substantial completion is practical completion, and the warranty walkthrough is the visit before the rectification period ends.

Why is final payment the last step before close-out?

Because it is the only leverage left. Once retainage is released, a contractor has little reason to deliver the manuals, record drawings and lien waivers still outstanding. The plan puts every closeout document and the back-checked punch list before the final certificate for payment, and it ships with a pre-logged risk that says so.

Can I see how many hours construction administration takes?

Per task, yes. Each task carries an estimate, and hours logged on a timesheet land on the task, so the time spent on submittals and RFIs, site visits and pay applications is recorded where it happened. Onplana does not yet roll that up into one figure for the phase, so comparing construction administration with its share of the fee is a sum you make from its tasks. The template itself runs on every plan, Free included.

Start with the plan already built

Open the Construction Documents and Closeout template free and your phases, tasks, and milestones are scheduled before the kickoff meeting. No credit card, no time limit.
